Tree Preservation Planning for Construction Projects on Oahu

Construction near mature trees needs a preservation plan. Root-zone protection, tree protection zones, and post-construction care explained.

· 6 min read

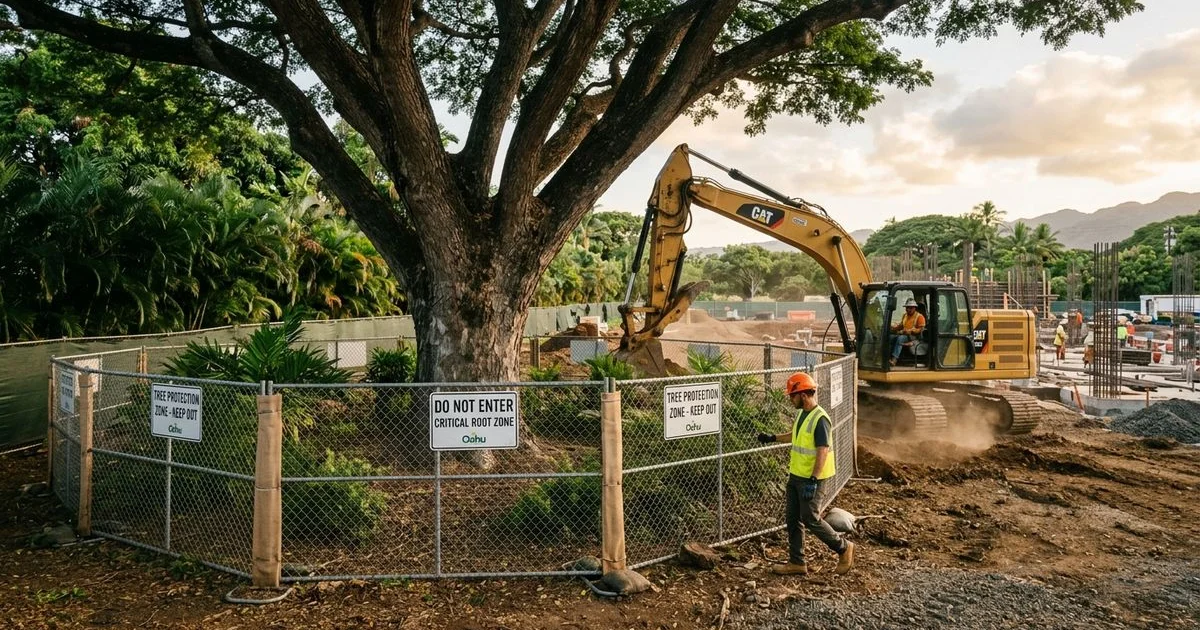

Tree protection zone around a mature tree at an active construction site

Why Construction Kills Trees

We often see mature trees mysteriously fail, and the cause almost always traces back to invisible damage from past projects. You know how easily heavy machinery compacts the soil or severs roots during a busy build. The damage happens during tree preservation construction phases, but the tree dies slowly, often 1 to 5 years after the project is complete.

Our team routinely traces these delayed deaths right back to grade changes and trenching.

This silent decline makes it hard for property owners to connect a dying tree to the work done years earlier. According to 2025 urban forestry data, up to 30% of trees die within the first five years after major site disturbances. Invisible damage usually falls into three categories:

  • Soil compaction from heavy machinery.
  • Severed roots from utility trenching.
  • Smothered root crowns caused by grade changes.

We consider a proper preservation plan the only way to keep mature trees healthy long after the final inspection. The arborist consultation process includes detailed preservation plans for both residential and commercial projects. Let us look at the data behind tree mortality, what a preservation plan actually entails, and how you can avoid costly mistakes on your next build.

Tree protection zone diagram

What a Preservation Plan Includes

A complete tree preservation plan Oahu projects require includes pre-construction assessments, designated tree protection zones, root protection strategies, and post-construction care guidelines. We build these plans to act as a clear, enforceable contract between property owners and construction crews.

Pre-Construction Assessment

A pre-construction assessment identifies which trees are worth preserving and calculates the specific protection zones they need. We start by conducting a tree-by-tree health and structural inspection before any equipment arrives. This step is critical because Honolulu regulations require special permits for Exceptional Trees.

The assessment documentation creates a baseline of pre-construction conditions. Our arborist maps the critical root zone radius for each tree. A standard formula uses a 1-foot radius for every inch of the trunk’s diameter at breast height.

Key elements of the assessment include:

  • Identification of high-value trees suitable for retention.
  • Root-zone mapping using the diameter at breast height calculation.
  • Photographic documentation of existing tree health.
  • Permit support for designated Exceptional Trees.

Tree Protection Zone (TPZ)

The Tree Protection Zone is a fenced area calculated to protect the critical root zone, keeping equipment, materials, and foot traffic safely away. We consider the TPZ the most important physical element of any preservation strategy. Strong chain-link fencing is standard practice in the US to ensure compliance.

Typical TPZ rules must be strictly enforced:

  • Fencing goes up before any work begins.
  • The barrier stays in place throughout the entire project.
  • No storage, equipment staging, or material piling inside the TPZ.
  • No grade changes inside the fenced area.
  • No trenching for utilities through the TPZ.

Our site managers often route utilities around these zones entirely. Doing so prevents accidental root severing that leads to tree death later.

Root Protection

Root protection involves using specialized techniques like air-spading to prevent root damage when excavation must occur near a tree. We always aim to keep trenches completely outside the critical root zone. If avoidance is impossible, specific routing minimizes the impact.

When trenching must occur, these practices are mandatory:

  • Trenches get dug carefully or air-spaded to preserve root systems.
  • Roots over two inches in diameter get cut cleanly, never torn by backhoes.
  • Mulch goes over the work area during recovery to retain moisture.
  • Temporary irrigation supports the tree immediately after root loss.

Our crews document these root cuts to track the tree’s stress levels. Proper cuts heal faster and reduce the risk of soil-borne pathogens.

Soil Protection

Soil protection strategies prevent heavy machinery from compacting the dirt and altering the natural drainage patterns the tree relies on. We lay down ground protection mats over the root zone if equipment must travel through it. Compacted soil strips roots of oxygen and prevents water absorption.

Common soil protection measures include:

  • Installing thick plywood or specialized ground mats for equipment routes.
  • Preventing grade changes, especially adding soil over the existing grade.
  • Maintaining original drainage patterns so the tree receives normal water flows.

Our soil management plans ensure the root crown remains exposed and breathing. Smothering roots with just three inches of fill dirt can suffocate a mature specimen.

Pre-Construction Pruning

Pre-construction pruning selectively removes branches to reduce the chance of construction machinery damaging the canopy. We plan this proactive pruning with the contractor before heavy equipment arrives on site. ANSI A300 pruning standards guide this process to ensure the tree is not over-stressed.

Our arborists often elevate lower branches to create clearance for tall machinery. A clean, planned cut heals much better than a jagged tear from an excavator arm.

During-Construction Monitoring

During-construction monitoring involves periodic site visits by an arborist to ensure protection measures are actively followed and to address unplanned issues. We catch many potential problems during these routine inspections. If a tree-protection fence gets moved or equipment encroaches the TPZ, it gets corrected immediately.

Our site checks provide a documented record of compliance for local authorities. When an unexpected root is encountered, professional guidance prevents catastrophic damage.

Post-Construction Care

Post-construction care provides watering, monitoring, and soil maintenance for 2 to 5 years after the build to support the tree’s recovery. We set up specific schedules because the stress of nearby construction takes time to manifest.

A solid post-construction care plan requires:

  • Watering schedules designed to support recovery and reduce drought stress.
  • Possible fertilization based on soil testing and tree response.
  • Routine monitoring for delayed decline or pest infestations.
  • Pruning of any damaged limbs that occurred during the build.

Our long-term care plans act as an insurance policy for your landscaping investment. Providing adequate water is the single most important factor in a tree surviving construction stress.

Arborist consulting with contractor and homeowner

Which Trees Are Worth Preserving

Trees worth preserving typically possess high replacement value, excellent health, aesthetic importance, or special legal protections. We help property owners evaluate every specimen to decide which ones justify the cost of protection and which can be removed. Not every tree is a good candidate for a preservation plan.

Our assessment process separates the canopy into protected trees, monitored trees, and trees slated for removal. Criteria for preservation include:

  • Age and replacement value. A 40-year-old monkeypod cannot be replaced easily, whereas a 5-year-old palm can.
  • Current Health. A declining tree may not survive construction stress regardless of protection efforts.
  • Exceptional Tree status. Some trees cannot be removed without permits in Hawaii and require significant effort to preserve.
  • Aesthetic and functional value. Large shade trees, privacy screens, and focal point trees add immense property value.
  • Construction conflict. Some trees sit directly in the building footprint and must come down.

We find it is better to plan a targeted removal than to try preserving a tree that is destined to fail. Prioritizing healthy, native species yields the best long-term results for preserving trees during construction Hawaii projects.

Why Builders Sometimes Resist Preservation Plans

Builders often resist preservation plans because they add upfront costs, limit staging areas, and introduce constraints to the construction timeline. We frequently hear pushback from contractors who view tree protection zones as inconvenient hurdles. Documentation matters because being “careful” without a formal plan still kills trees.

Our arborists hear several common pushback points on job sites:

Contractor ObjectionArborist Response & Reality
”It will be fine, we will be careful.”Careful without a plan still kills trees. Fines for damaging protected trees are severe.
”The fencing is in the way.”That is the point. The TPZ has to stay protected from heavy machinery.
”We need to grade through there.”Then route around the roots or accept that the tree will not survive the build.
”It is just one trench.”One trench severing a critical root zone can kill a mature tree within three years.

A good preservation plan must be signed off by the contractor as a condition of the work. We require this documentation before any heavy machinery arrives on site. It is not optional, and it is not flexible without an arborist’s approval. The city of Honolulu can issue a stop-work order if tree protection zones are violated.

What It Costs

Preservation plans usually cost between a few hundred and a few thousand dollars, depending heavily on the scope of the project and the number of trees. We view this modest expense as the cheapest insurance policy in your entire project budget. Compared to losing a mature tree, which can wipe out tens of thousands in property value, the upfront cost is negligible.

Our commercial clients know that preservation planning is often a mandatory part of the permit process. For commercial and Exceptional Tree projects, the City and County of Honolulu requires these plans before breaking ground.

Failing to comply with local regulations can be incredibly expensive.

In Honolulu, fines for illegally removing or damaging an Exceptional Tree can reach up to $5,000 per violation.

We save property owners from these heavy fines by establishing clear protocols early. A well-planned project protects the environment and the bottom line.

Bottom Line

Building near mature trees without a preservation plan remains the most common way large trees die on Oahu. We consider these plans basic risk management, not an optional luxury.

Skipping the planning phase guarantees that construction damage will show up as tree death 1 to 3 years later.

Our recommendation is to bring an ISA-certified arborist in before construction starts. Build the protection plan directly into the project budget, and ensure your trees survive the build. Contact our team today to schedule an initial site assessment and protect your landscape.

FAQ

Common Questions

How do I protect trees during construction?
An arborist establishes tree protection zones, root-zone safeguards, and a monitoring plan before and during the build.
Do you work with builders and developers?
Yes. We provide preservation plans, reports, and on-site monitoring for construction projects, especially those involving Exceptional Trees.
What's the most common cause of construction tree death?
Compacted soil over the root zone and severed roots from trenching. Both happen during typical construction unless specifically prevented.

Need expert help on this?

Learn more about Arborist Consultation & Plant Health

See our Arborist Consults service
24/7 emergency dispatch on Oahu

Ready for Expert Tree Care on Oahu?

ISA-certified arborists, transparent pricing, and 24/7 emergency response. Get a free on-site quote today.

ISA Certified Arborists Licensed & Insured Free On-Site Estimates
